Most COI compliance programs are built around a single standard, but Commercial GCs don't work with a single standard. Owner mandates vary. Endorsement requirements vary by project type and contract. The subcontractor who is fully compliant on one project may not meet the requirements on the next. A program that does not account for that variation is not actually tracking compliance. It is tracking paperwork.
Managing all of that across your subcontractors, through a shared inbox, a spreadsheet, or a system that tracks at the vendor level, is how compliance exposure builds quietly until something forces it into view.
The commercial GC compliance challenge
The compliance challenge for commercial GCs is not just volume. It is volume combined with variation.

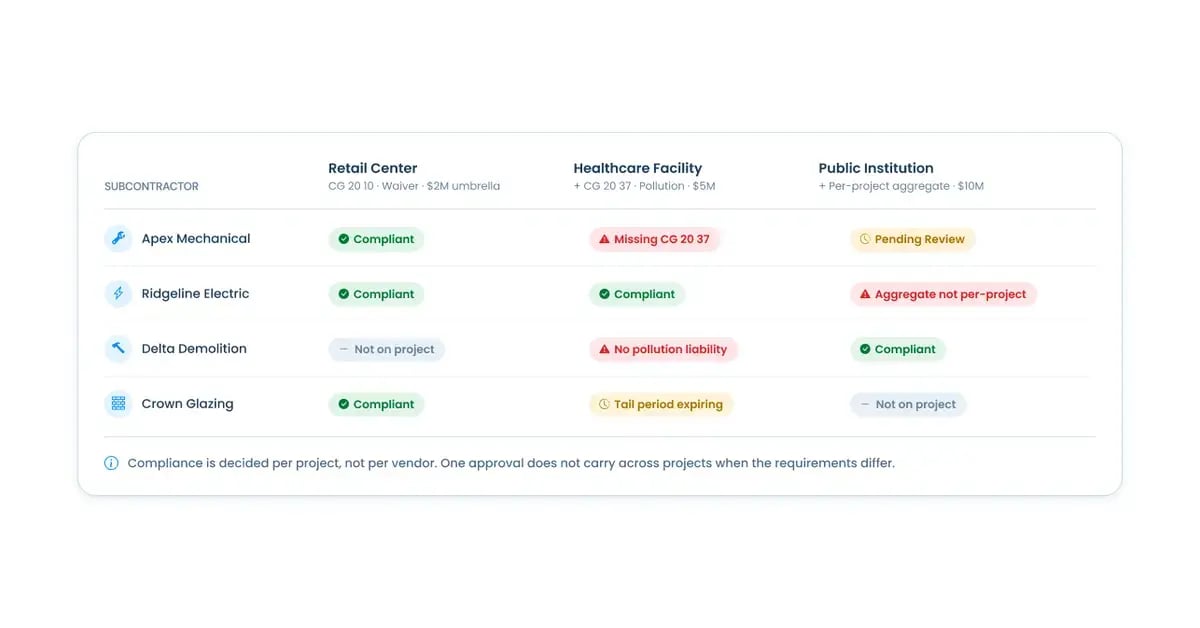

A commercial GC with 15 active projects and 250 active subcontractors is not tracking 250 certificates against a single standard. Each project may carry different owner-mandated endorsement requirements. A healthcare owner may require higher per-occurrence limits and pollution liability for certain trades. A public institution may require per-project aggregate endorsements. An owner using AIA A201 with supplementary conditions may require endorsement language that departs from the standard form entirely.
The subcontractor whose certificate is on file and approved for one project may not meet the requirements for the next. And if your compliance program sets requirements at the vendor level rather than the project or contract level, that distinction gets missed.
What commercial construction contracts require
Commercial construction contracts, particularly those based on AIA A201 and owner-specific supplementary conditions, require the standard endorsement package that most GC contracts specify: additional insured status, primary and non-contributory language, waiver of subrogation, and workers compensation coverage with appropriate limits. For a full breakdown of what to collect and verify from every subcontractor, see COI Compliance in Construction: What GCs Need to Track.
What varies in commercial construction is the owner layer on top of that standard. Supplementary conditions frequently increase base requirements. Per-project aggregate endorsements are common on commercial projects where the owner wants limits that apply specifically to their project rather than shared across the sub's full book of work. Pollution liability is often required for excavation, demolition, or renovation trades. Professional liability is standard for design-build subcontractors and engineers. Umbrella requirements regularly exceed the AIA A201 baseline.
The same subcontractor working across multiple commercial project types needs endorsements that meet each owner's specific requirements. A standard vendor-level approval does not carry across projects when the requirements differ.
Where commercial GC compliance programs fall short
Endorsement verification stops at the certificate.
A certificate that shows additional insured status does not confirm that the endorsement uses CG 20 10, that it names the right entities, or that it covers completed operations separately under CG 20 37. That distinction matters at claim time. A general insured endorsement does not provide the same protection as a scheduled endorsement naming the owner and GC specifically. Verifying the endorsement language requires reading the actual endorsement document against your contract requirements. A checked box on the certificate is not confirmation.
Requirements set at the vendor level do not account for project variation.
A subcontractor approved at the vendor level carries that approval forward even when project requirements change. When the same mechanical subcontractor moves from a retail project to a healthcare facility with stricter endorsement requirements, a vendor-level compliance system may not catch the discrepancy. The certificate on file was reviewed and approved. The new project requirements were never applied to it.
Completed operations coverage is not tracked through the tail period.
Commercial construction liability does not end at substantial completion. Defects discovered years after project closeout can trigger claims under the completed operations portion of a subcontractor's general liability policy. The CGL products-completed operations aggregate is a separate limit from the general aggregate and must remain in force through the contractual tail period, often two to five years after project completion. A compliance program that closes out a subcontractor's record at project completion misses this entirely. For how a lapsed COI creates direct cost at audit time, see How COI Tracking Protects You in a Workers Comp Audit.
Project compliance records are not independently auditable.
When an owner or their insurance representative asks for documentation of subcontractor compliance on a specific project, the compliance record needs to be organized by project with every decision logged against the applicable requirement set for that project. A vendor-level compliance record does not produce that output cleanly.
Managing requirements by project and contract
A compliance program that handles the variation commercial GCs deal with needs to set requirements at the project or contract level. The same subcontractor can carry different requirement sets depending on the project they are working on. When a renewal certificate comes in, the review needs to check it against the requirements for that specific project and contract, not a generic vendor-level default.
This also means the compliance record for each project needs to be independently auditable. When an owner or their insurance representative asks for documentation of subcontractor compliance on a specific project, the record should be organized by project, with every approval, rejection, waiver, and exception logged against the applicable requirement set.
How PINS handles commercial GC compliance
PINS is built for teams managing multiple active projects with varying subcontractor requirements. Requirements are configured at the project, contract, or vendor level and applied automatically to every submission against that requirement set. When a subcontractor submits a renewal certificate, the PINS AI Assistant reviews it against the applicable project requirements and returns findings with evidence linked to the specific language in the endorsement document. Your team reviews the result and makes every compliance decision.
For teams running on Procore, commitments flow from Procore into PINS automatically. Compliance status writes back to Procore in real time, tied to each commitment, so project managers see current status without logging into a separate system. See How the PINS and Procore Integration Works for a full walkthrough.
Every approval, rejection, waiver, and exception is logged with a timestamp and the name of the person who made the call. When an owner audit arrives, the compliance record is already organized and retrievable.
For commercial GCs evaluating COI tracking software, download the COI Tracking Software Evaluation Checklist: 22 questions across 8 categories to bring into every demo.
For a full overview of how PINS works for commercial construction teams, see COI Tracking for Commercial Construction.
Frequently asked questions
What is the best COI tracking software for commercial general contractors?
The best COI tracking software for commercial general contractors handles the specific complexity of managing requirements across multiple active projects with different owner mandates. Key capabilities to look for: requirement templates that can be set at the project or contract level rather than just the vendor level, endorsement language verification against your specific contract requirements rather than just certificate collection, completed operations tracking through the contractual tail period after project closeout, an audit-ready compliance record organized by project, and native integration with Procore for teams where project managers need visibility into compliance status without logging into a separate system. PINS is built for commercial GC teams managing this level of variation. See COI Tracking for Commercial Construction for a full overview.
How do endorsement requirements vary across commercial construction projects?
Endorsement requirements in commercial construction vary primarily by owner mandate and project type. A retail tenant improvement project may require standard AIA A201 endorsements. A healthcare facility project may require higher limits, pollution liability for trades involved in renovation, and specific completed operations tail requirements. A public higher education project may require per-project aggregate endorsements that are not standard on commercial projects. The same subcontractor working across different commercial project types needs to carry endorsements that meet each owner's specific requirements. A vendor-level approval on one project does not carry over to a project with different specifications.
Why is completed operations coverage important for commercial GCs?
Completed operations coverage protects against liability claims that arise after project completion, including construction defect claims that may surface years after the project closes out. The CGL products-completed operations aggregate is a separate limit from the general aggregate and must remain active through the contractual tail period specified in the contract, often two to five years after substantial completion. A subcontractor whose completed operations coverage lapses after project closeout leaves the GC exposed on any claims arising from that sub's work during the tail period. COI tracking programs should monitor completed operations coverage separately from ongoing operations coverage and track it through the required tail period.
What is the difference between vendor-level and project-level COI requirements?
Vendor-level COI requirements set a single standard for a subcontractor that applies across all projects they work on. Project-level requirements set specific standards for each project based on the owner's contract requirements and the risk profile of that particular scope of work. For commercial GCs working across multiple project types with different owners, project-level requirements are more accurate. They ensure that each subcontractor's coverage is reviewed against the actual requirements of the project they are on, not a generic standard that may be higher or lower than what the contract actually requires.
How does COI tracking software handle multiple concurrent projects for commercial GCs?
COI tracking software built for commercial GCs allows requirement templates to be configured by project, contract type, or owner specification. When a subcontractor works across multiple projects, each project's requirement set is applied independently to the submissions for that project. A renewal certificate is reviewed against the applicable project requirements, not a generic vendor default. The compliance record for each project is organized and auditable separately, so an owner or auditor requesting documentation for a specific project gets a complete record of that project's compliance history without having to sort through records from other projects.
